When buyers compare stretch wrapper and strapping equipment,the first questions are usually about the machine itself:turntable size,guardrail length,strapping speed.For a large manufacturing company,however,the real decision-maker is often something else—whether the supplier can hold every stage of the project together,from the first requirement call to final commissioning.
Between July and September 2026,Shandong Dyehome(jinan,China)delivered a custom stretch wrapper&strapping combination machine—with turntable and guardrail accessories,a large electronics manufacturer in South China.Key milestones:
July 2,2026—A dedicated project group was set up,and the first round of requirement confirmation was completed the same day.
Aug 28,2026—The machine shipped on the agreed date.
Early September 2026—On-site assembly and commissioning were completed,and the handover closed out on Sept 7.
This real project shows what full-process delivery service looks like—and why it matters as much as the machine itself.
Why Service Capability Comes First When You Buy a Wrapping and Strapping Combo Machine
A stretch wrapper&strapping combination machine is highly customized and tightly coupled to site conditions.Frame,turntable,guardrails,door position,guardrail routing,and conveyor interfaces all have to match a specific factory floor.One mismatch can leave a delivered machine unable to run.
Large buyers also answer to internal rules:safety standards to pass,site-entry documents to submit item by item,installation and training slots to book,and appearance and accessories to verify against a checklist.For them,the supplier's responsibility starts long before the machine is built:
1.At the requirements stage—can the supplier absorb a long,detailed requirement list and respond fast?
2.At the drawing stage—can colors,dimensions,and layouts be aligned,then realigned?
3.During production—can the client see real progress without visiting the factory?
4.At shipping and site entry—are loading methods,documents,and registration requirements prepared in advance?
5.On site and after sales—do people,materials,and documents all arrive on time?
Below is how Shandong Dyehome handled each of these in one real project.
7 Stages of a Full-Process Delivery Service
Stage 1:Requirement Alignment—First Review Completed the Same Day
On the morning of July 2,the project group was created.That same day,the client confirmed its requirement list,and Dyehome replied with receipt confirmation and started the review.General design documents were pre-reviewed,and unclear points were raised before the next day's meeting.When the client asked technical feasibility questions,answers came back within 15 minutes.
That afternoon,both sides agreed the schedule:design would start from the date of first communication,while the final delivery milestone stayed unchanged.
Stage 2:Design and Drawings—Color,Layout,and Dimensions Checked Against Reality
Color was verified through two-way calibration.The technical engineer first sent light gray color swatches;the sales consultant then shared workshop photos showing how the column color actually looked.The client compared multiple color cards,asked about paint finish,and the machine color and turntable color were finalized at a mid-July meeting.
Layout details got the same attention.Door position and guardrail routing were aligned one by one against photos of the client's actual site.In late July,when drawing dimensions and on-site measurements did not match,both sides rechecked immediately and arranged re-measurement as needed—stopping alignment and installation risks before the machine ever shipped.
Stage 3:Production Transparency—Real Photos,Week by Week
Materials arrived in mid-August and assembly entered its final sprint.Dyehome shared real workshop photos at every milestone:material arrivals,evening assembly shifts,and the frame being stood upright and lifted into place.The client's weekly progress meetings cited these photos directly.
3D renderings were also annotated part by part at the client's request,so internal structures were visible before they existed on the floor.
Stage 4:Documentation Coordination—Itemized Tasks,Same-Day Alignment
The client's standards required a full set of site-entry documents.Dyehome split the checklist into items and assigned each one an owner.Items produced by Dyehome were completed the same day;the remaining items were explicitly assigned to the client to fill in.Scope boundaries around staffing and work procedures were clarified in parallel,so responsibilities were cut clean and fast.
Stage 5:Shipping and Site Entry—Everything Prepared Before the Truck Left
In late August,a conference call locked the schedule:shipping on the agreed date of Aug 28,arrival at the client's site in early September,and rigging,assembly,and commissioning planned down to the day.The client repeated the schedule back on the call to confirm.Layout drawings and installation and construction documents were delivered the same day.
Loading was handled with equal care.The loading video was shared with the client,and its anti-collision reminders were adopted.The lower frame shipped upright so it could be bolted directly to the floor after on-site lifting.Registration requirements were passed to the carrier in advance.
Stage 6:On-Site Assembly—Step Lists and Spare-Parts Lists Arrived First
Just before shipping,Dyehome delivered an assembly step list with a timeline and urgently prepared a spare parts and accessories list.On-site training staffing and personal protective equipment were also arranged ahead of time.

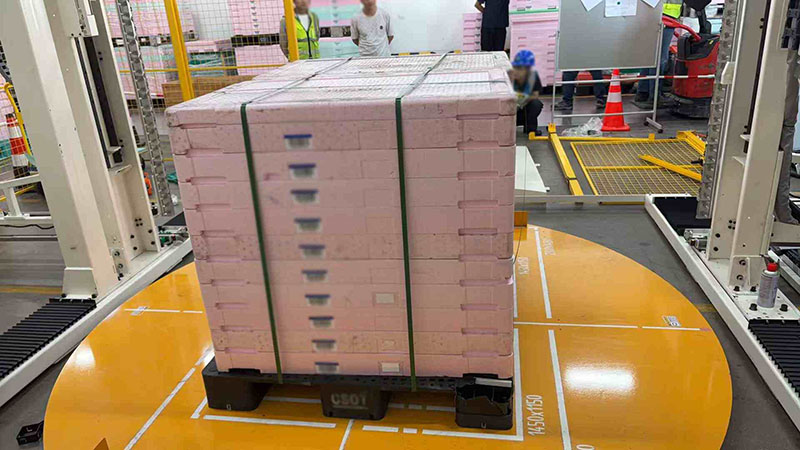

In early September,the machine was moved in,lifted,assembled,and commissioned according to the schedule.On Sept 7,installation completion photos came back for confirmation—white equipment with yellow safety guardrails,and more than two months of coordination captured in a single frame.
Stage 7:After-Sales Wrap-Up—Contingency Ready Before Arrival
When the machine arrived in early September,the appearance inspection plan was already in place.Touch-up paint material had been pre-shipped with the machine,so any touch-up request could be handled the same day it was raised—no waiting for a second shipment.The operation and maintenance manual was delivered on schedule,and once on-site installation was confirmed,the project moved into after-sales support.The delivery loop was closed.
5 Reasons Buyers Choose Shandong Dyehome
1.Hour-level requirement response.The first requirement and milestone review was completed on the day the project group was created,with proactive pre-review before meetings and a structured question list brought to the table.
2.Transparent,traceable milestone management.Delivery is managed on a Gantt chart and milestone list.Any adjustment generates a fast new version,shared with the client,with the impact of the change explained up front.
3.Two-way verification at the design stage.Colors are calibrated with color cards plus real photos;dimensions are checked against drawings plus on-site measurement;layouts are aligned using photos of the actual site.
4.Production you can see and trust.Key assembly milestones are documented with real photos,so clients track genuine progress without visiting the workshop.
5.Delivery that ends in closure.Assembly step lists,spare parts lists,operation manuals,training staff,and touch-up paint materials are all staged and ready at each delivery milestone.
Get a Customized Delivery Plan
For buyers of stretch wrapper&strapping combination machines,the machine is the starting point—service is what gets it running.Shandong Dyehome manufactures stretch wrapper&strapping combination machines and stretch film wrapping machines,and offers one integrated delivery package:requirement alignment,design,transparent production,shipping coordination,and on-site assembly.
Tell us about your product dimensions,pallet size,line speed,and site layout.Send an inquiry through our official website and we will respond with a tailored proposal and a concrete delivery schedule for your project.
